Indermuehle & Co. Breaks Ground on New 11,000 SF Company Headquarters in Sugar Land, Texas
January 25, 2006 (Sugar Land, Texas) - Indermuehle & Co. broke ground on their new office building in Sugar Land, Texas. Construction completion is anticipated to be August 2006.

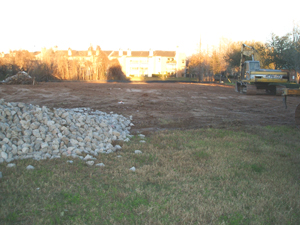

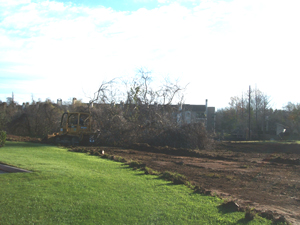

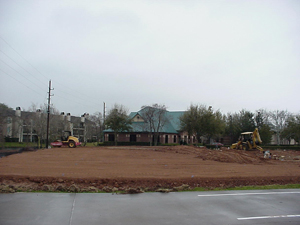

2006-01-30 Site Clearing & Stripping
General Contractor clears site of all unnecessary brush and dying trees.

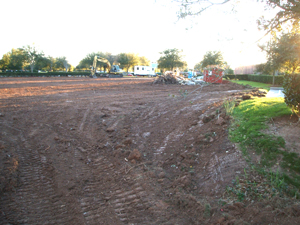

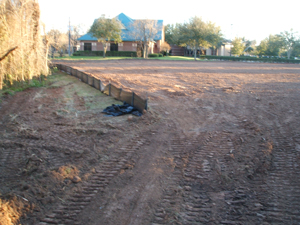

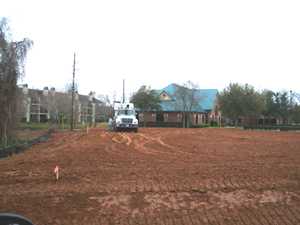

2006-02-01 Site Contoured
After site was cleared of debris; site was contoured to begin shaping lot as well as handle potential run-off water during initial construction phase.

2006-01-27 Site Skirt Constructed
Skirts were added to site perimeter to prevent run-off erosion.
2006-01-30 Rock Entryway Created
A rock entryway was created in an effort to stabilize heavy traffic upon site entry and site exit.

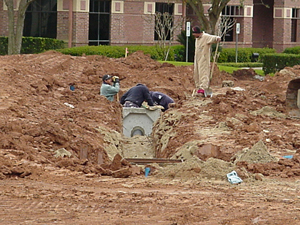

2006-01-31 Power Pole Installed
CenterPoint Energy installed power pole to provide electrical service to the service trailer and building when available.

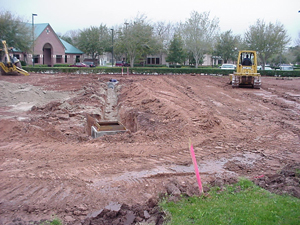

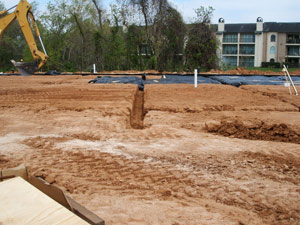

2006-02-02 Main Storm Drain Line Installed
Main storm drain at the northeast corner of lot catches both run-off building gutters and parking lot.

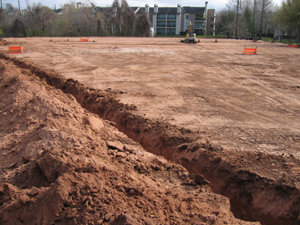

2006-02-06 Site Compacting
Slab site is leveled and compacted.

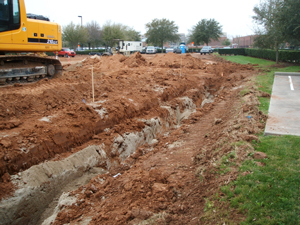

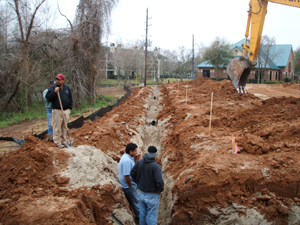

2006-02-07 Ditch Run Length of East Side
Line run along west side of lot for drainage.
2006-02-08 Front Parking Lot Storm Sewer
Storm drain in center of front parking lot.
2006-02-09 Front Corner Storm Drain Culvert
Front corner storm drain culvert services water from parking lot and front building gutter system.

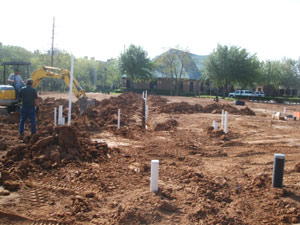

2006-03-03 Sanitary Sewer Line Run
Sanitary sewer line runs from front of building to street.
2006-03-10 Sanitary Sewer Drains
Sanitary sewer line running the width of the building.

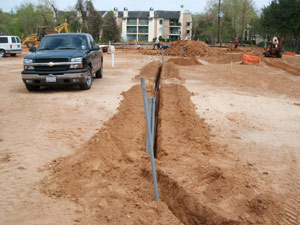

2006-03-15 Conduit for Phone Lines
Under ground phone lines being installed.
2006-03-22 Covering the Site with Vapor Barrier
Waffle grid trench lines being cut into the foundation pad.

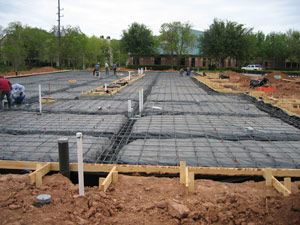

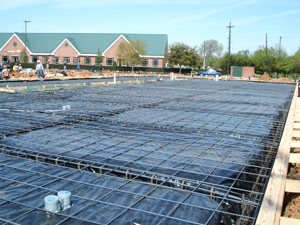

2006-03-24 Waffle Slab Rebar Before Concrete
Finished waffle grid foundation pad ready for concrete to be poured.
2006-03-04 Waffle Slab Rebar Before Concrete
Plumbing lines and sanitary sewer leave-outs stubbed in.

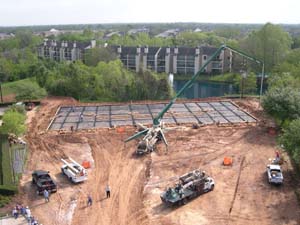

2006-03-31 Aerial View of the Concrete Pump Truck
Concrete pump truck setting up for pouring concrete pad.

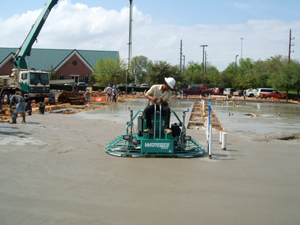

2006-03-31 Troweling out the Concrete
Troweling the concrete to finish floor.

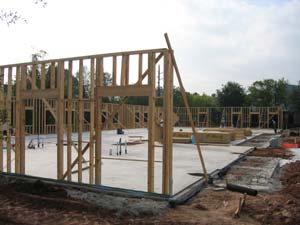

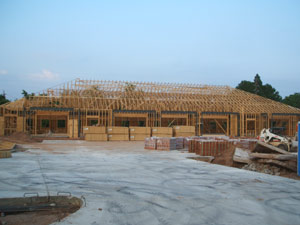

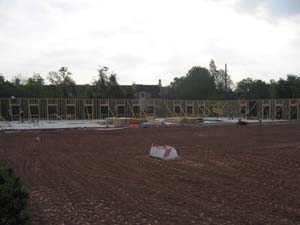

2006-04-04 Framing
Framing of exterior building walls.
2006-04-04 Framing
Framing of exterior building walls.

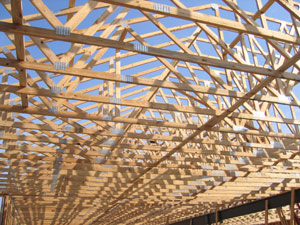

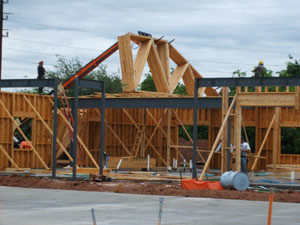

2006-04-25 Roof Trussers
The roof trussers being installed.

2006-04-25 Roof Trussers
Completed roof trussers system allows clear span.

2006-04-26 Roof
Roof decking delivered, plywood roof to be installed next.

2006-05-05 Roof
Roof deck being applied.

2006-05-05 Roof
Roof asphalt paper being secured.

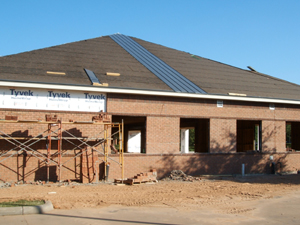

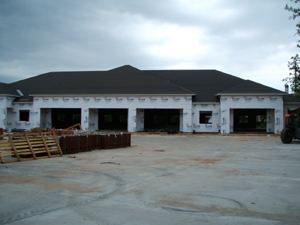

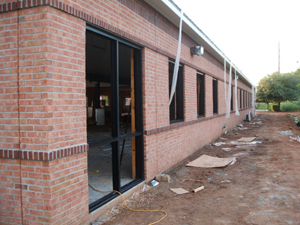

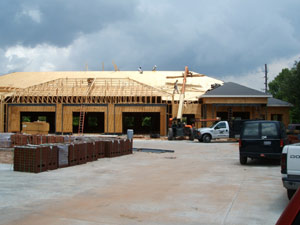

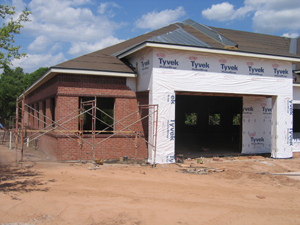

2006-05-19 Exterior Brick
Exterior brick finish being applied.
2006-05-31 Roof
Roof asphalt paper being secured.

2006-05-31 Exterior Brick

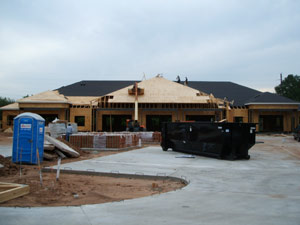

Brick finish progresses. Start standing seam metal roof.

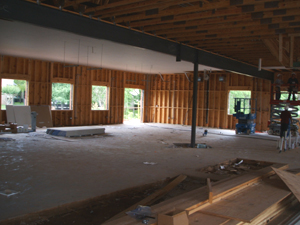

2006-05-31 Building shell
First interior look of shell building.
2006-05-31 Complete Shell
Rear view of completed shell building.

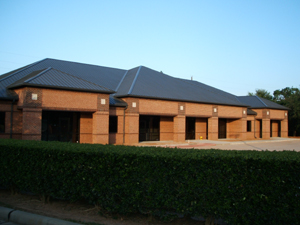

2006-06-10 Completed Shell
Front view of completed shell building.
